Manually Updating Colour Visuals as Approved

Abstract

In the normal course of events, when a customer is notified that colour visuals are awaiting their approval, the customer logs onto a TOT Shirts Limited web portal and approves the items



Once approved, the art room will continue with tasks required to create the final artwork necessary for usage in the production processes for the customer's job order. Crucially, until colour visuals are approved,  no further work is performed with respect to the artwork.
See Understanding ArtWork for an overview of the typical workflow.



Customer approval from the website is electronic and automatically updates the Artwork record's colour visual's approval status as approved in strokeone.



However, there can be scenarios where the customer is either unable or unwilling to use the website to approve their visuals.

Recognising this,  flexibility has been built into strokeone  to allow for an alternate method of recording approval, so that the Artwork creation tasks can continue. .



To manually update colour visuals as approved, follow the steps below :-

Prerequisites

Ensure that you have opened the  Art to Be Done Summary layout.

Procedure

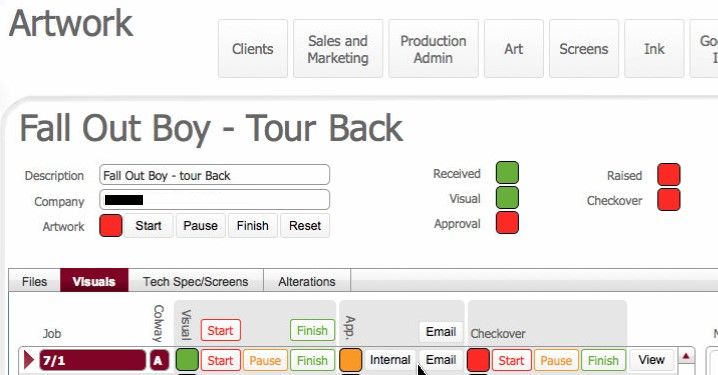

  1. Locate the Artwork record that the you wish to record approval of Colour Visuals for.
    Tip: The record should have the following statuses
    Received: Complete
    Visuals: Complete
    Approval: In Progress
  1. Open the Artwork required identified in step 1)
  2. Ensure that you have selected the Visuals tab.
  3. Locate the job line record which has the colour visuals you are going to update as approved.
  4. Click to select the record in step 4)
  5. Optionally, you may wish to click the View button to double check the visuals in the container fields, to ensure you have selected on the correct record.
  6. Click the Internal button for the record selected in step 4)


  7. The Approval status for the record is updated from In Progress to Complete.
